One bathroom. Four people. That is the math that makes homeowners nervous about a bathroom remodel. The tile may be dated and the vanity may be falling apart, but the thought of losing the only full bath for an unknown stretch of time keeps the project on hold.
The uncertainty is the hard part, not the inconvenience. Most families can work around two or three weeks if they know the finish date. What wears people down is a project that starts with a vague estimate and drifts.
This guide lays out the actual schedule. Each phase, how long it takes, why certain steps cannot be rushed, and what pushes a project past the normal range. By the end you will be able to look at your own bathroom and estimate the timeline with reasonable accuracy.
Most Bathroom Remodels Take 2 to 4 Weeks
A standard bathroom remodel typically takes 2 to 4 weeks of on-site construction, from demolition through the final walkthrough. This timeline assumes the existing layout stays mostly the same, materials are ready before work begins, and no unexpected issues are discovered behind the walls.
Smaller Bathrooms Can Take Less Time
A powder room or simple guest bathroom update may be completed in 7 to 10 days. Larger primary bathroom remodels can take longer, especially when they include custom showers, freestanding tubs, heated floors, or relocated plumbing. These projects may take 5 to 7 weeks to complete.
Material Availability Can Affect the Timeline
Most Central Texas bathroom remodeling projects can stay within the 2-to-4-week construction window when all materials are on site before work begins. Delays can occur when plumbing needs to be moved, a fixture is backordered, or unexpected problems are found during demolition.
Plan for More Than Just Construction
The actual construction period is only one part of a bathroom remodel. Design, product selection, material ordering, and permits can add another 2 to 6 weeks before demolition begins.
For most homes in Central Texas, a realistic start-to-finish timeline is about 4 to 10 weeks. Getting your selections and materials finalized early can help keep the project moving without unnecessary delays.
Why Bathrooms Take Less Time Than Kitchens
Bathrooms are smaller and have fewer long lead components. There is one vanity instead of a full run of cabinetry. There is a few square feet of countertop instead of twenty. Appliances are not part of the equation.
But bathrooms have their own bottleneck: water. Every square inch of a shower has to be waterproofed correctly, and waterproofing involves cure times that cannot be shortened. A skipped cure time today becomes a leak behind tile in three years. Cure times cannot be compressed the way ordering can, so a small bathroom and a large kitchen can occupy similar stretches of the calendar for completely different reasons.

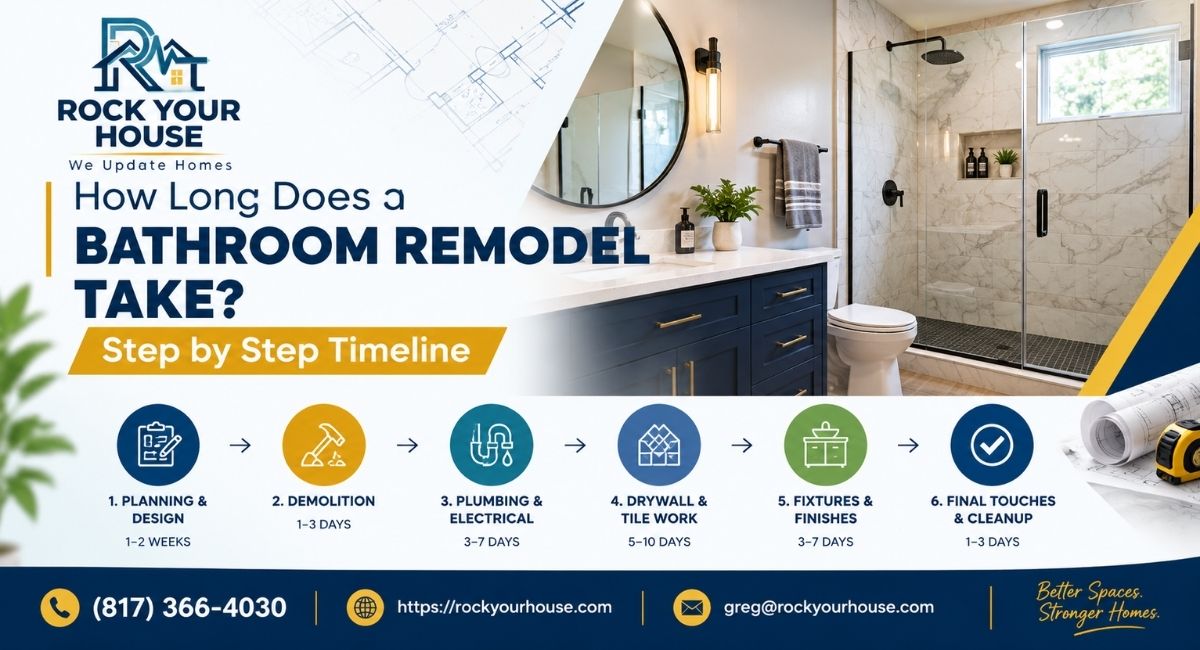

Bathroom Remodel Timeline by Phase
Here is a typical breakdown for a full bathroom remodel with a tiled shower. Some phases overlap, and small bathrooms compress several of these into single days.
| Phase | Typical Duration | What Happens |
| Consultation and estimate | 2 to 5 days | Site visit, measurements, scope review, written proposal |
| Design and selections | 1 to 2 weeks | Layout, tile, vanity, fixtures, shower glass, lighting |
| Ordering and permits | 1 to 5 weeks | Materials ordered, permit submitted if plumbing moves |
| Demolition | 1 to 2 days | Tile, tub or shower, vanity, toilet and flooring removed |
| Rough plumbing and electrical | 2 to 4 days | Valve and drain work, new circuits, exhaust fan, inspection |
| Shower pan and waterproofing | 2 to 4 days | Pan built or set, membrane applied, cure time observed |
| Backer board and drywall | 2 to 3 days | Cement board in wet areas, drywall repair elsewhere |
| Tile setting and grout | 3 to 6 days | Wall and floor tile, then grout after thinset cures |
| Vanity, fixtures and trim | 2 to 4 days | Vanity set, countertop, toilet, faucets, paint, hardware |
| Shower glass and punch list | 1 to 2 weeks | Glass measured after tile, fabricated, then installed |
Notice the last row. Custom shower glass is measured after tile is finished, not before. Fabrication commonly takes one to two weeks. Many bathrooms are fully usable during that wait with a temporary curtain, but the project is not officially complete until the glass is in.
Phase One: Consultation and Planning
A contractor visits, measures the room, checks the existing plumbing configuration, and looks at the ceiling below if there is one. That last step matters. Signs of past leaks change the scope before anyone commits to a price.
You will discuss what stays and what goes. Keeping the tub in place is faster than converting it to a walk in shower. Keeping the toilet flange where it is avoids cutting concrete. Every decision at this stage has a time cost attached.
A written estimate usually arrives within a few days. Ask for a line item breakdown. Knowing typical local numbers helps here, and reviewing typical bathroom remodel cost in Central Texas figures gives you a reference point before comparing bids.
Slab Foundations Change the Math
Most homes across Central Texas sit on concrete slabs. Moving a drain line in a slab home means cutting concrete, rerouting the pipe, inspecting the work, and pouring new concrete. That adds three to six days and often triggers a permit.
Homes with pier and beam foundations or a crawl space allow plumbers to work from below, which is faster and less disruptive. Ask which type you have before assuming a layout change is simple.
Phase Two: Design and Product Selections
Bathroom design usually takes one to two weeks. The room is small, but the number of decisions is high. Tile size, tile layout, grout color, niche placement, vanity width, countertop material, sink style, faucet finish, toilet height, lighting, mirror, exhaust fan, and glass configuration.
Finish selections matter more in a bathroom than in most rooms because everything is visible at close range. A small space makes every transition, every grout line, and every edge detail noticeable.
Tile Decisions Drive the Labor Schedule
Tile choice affects installation time directly. Large format porcelain covers area quickly but needs a very flat substrate and careful leveling. Mosaic and penny tile cover slowly and need far more grout work. Herringbone and chevron patterns generate more cuts and more waste.
Natural stone adds sealing steps. Marble needs sealing before grout and again after, since grout pigment can stain porous stone. Each of those steps adds hours of drying time to the schedule.
Showers, Tubs and Conversions
A prefabricated shower unit installs in a day or two. A fully tiled custom shower takes a week or more once waterproofing and curing are included. Both are good options, but they represent different timelines.
Tub to shower conversions are common in homes where children have grown up. If the drain location works with the new layout, the conversion is straightforward. If the drain has to move, add slab work to the schedule.
Vanities and Countertops
Stock vanities from a supplier arrive in days. Semi custom vanity cabinets take four to eight weeks. Custom built vanities can take longer. Vanity tops are often sold as prefabricated units with integrated sinks, which avoids the template and fabrication wait that slab countertops require.
If you choose a slab quartz or granite top, expect the same sequence used in kitchens. Template after the vanity is installed, then one to two weeks of fabrication before the top arrives.
Cure and Dry Times You Cannot Skip
This is the part of a bathroom schedule that surprises homeowners most. Several steps require waiting, not working. The crew is not being slow. The materials are doing their job.
| Step | Typical Wait Time | Why It Matters |
| Liquid waterproofing membrane | 12 to 24 hours | Must fully cure before tile or flood testing |
| Mortar bed shower pan | 24 to 48 hours | Needs to harden before the membrane or tile goes on |
| Shower pan flood test | 24 hours | Confirms no leaks before anything gets covered |
| Thinset under tile | 24 to 48 hours | Tile must be stable before grout is applied |
| Grout before sealing | 24 to 72 hours | Sealing too early traps moisture in the joints |
| Silicone caulk at corners | 12 to 24 hours | Needs to skin over before the shower is used |
| Primer and paint coats | 2 to 4 hours between coats | Bathroom humidity can extend this window |
| Concrete patch after slab work | 24 to 72 hours | Must set before flooring is installed over it |
Cure times stack. A shower that needs a mortar bed, a membrane, a flood test, tile, and grout has four separate waiting periods built into it. That is why a custom tiled shower rarely finishes in under a week even with a crew on site every day.
Technical standards for tile installation and waterproofing are published by the Tile Council of North America, which is the reference most professional installers follow for shower assemblies and substrate requirements. Asking a contractor which method they use is a reasonable question.
Permits and Inspections for Bathroom Remodels
Permit requirements depend on scope and city. Replacing a vanity, retiling a floor, swapping a toilet, and repainting typically do not require a permit in most jurisdictions.
Permits usually become necessary when you relocate plumbing fixtures, add electrical circuits, install a new exhaust fan with new ducting, or make structural changes such as widening a doorway. Converting a tub to a shower may require a permit if the drain moves or the valve is replaced.
Review times vary across the Austin metro. Some offices approve simple residential permits within days. Others take two to three weeks. Local familiarity matters, and a contractor handling bathroom remodeling in Cedar Park TX already knows which details that office wants, which usually prevents a resubmittal and the week it costs.
Inspection Timing Inside the Schedule
When a permit is pulled, an inspector must see the rough plumbing and electrical work before walls are closed. If the inspector is booked several days out, backer board waits. That pause is built into any realistic schedule.
Some jurisdictions also require a shower pan inspection before tile goes on. This is a good thing. It confirms the waterproofing is sound while it can still be corrected easily.
Phase Three: Demolition
Bathroom demolition takes one to two days. The crew shuts off water, protects hallways and floors, and removes the vanity, toilet, tub or shower, tile, and flooring. Old tile mortar beds are heavy and slow to remove, which is why some demolitions run longer than expected.
This is where hidden conditions appear. The most common finding is water damage. A shower pan that failed years ago may have rotted subfloor, damaged studs, or fed mold growth inside the wall cavity.
Repairing that damage adds time. Structural repair to a rotted joist can add two to five days plus a possible inspection. This is also why a contingency of 10 to 15 percent is a sensible part of any bathroom budget.
• Water damaged subfloor or wall framing behind the shower
• Old galvanized supply lines that need replacing
• Ungrounded outlets or missing GFCI protection
• An exhaust fan venting into the attic rather than outside
• Cast iron drain lines nearing the end of their service life
Phase Four: Rough Plumbing and Electrical
Rough in work takes two to four days in most bathrooms. Plumbers set the shower valve, adjust drain positions, and install supply lines for the vanity and toilet. Electricians add GFCI protected circuits, wire vanity lighting, install the exhaust fan, and run power for any heated floor system.
Heated floors deserve a note. An electric mat system needs its own circuit and a thermostat, and it has to be tested for continuity before, during, and after tile installation. It adds roughly a day of labor but significantly improves comfort in tiled bathrooms.
Ventilation is worth doing properly. An exhaust fan should vent to the exterior, not into the attic. Correct ventilation protects the new finishes from the humidity that damaged the old ones.
Phase Five: Shower Pan and Waterproofing
This phase determines whether the bathroom lasts twenty years or fails in five. It takes two to four days including cure time, and it is the phase most worth protecting from schedule pressure.
There are two common approaches. A traditional mortar bed pan is built on site and sloped toward the drain, then covered with a waterproof membrane. A foam pan system uses a pre sloped preformed base with a bonded membrane, which installs faster and produces very consistent results.
Wall waterproofing follows. Either a liquid applied membrane rolled over cement backer board, or sheet membrane bonded to the substrate. Corners, seams, and the curb get extra attention since those are the common failure points.
The Flood Test
A flood test plugs the drain, fills the pan with water, and leaves it for 24 hours. A drop in water level means a leak that must be fixed before tile goes on.
Skipping this test saves a day. Finding a leak after tile is installed costs weeks and thousands of dollars. Ask whether a flood test is included and treat a yes as a sign of a careful contractor.
Phase Six: Tile Setting and Grout
Tile work takes three to six days for a typical bathroom. Floor tile and shower wall tile are usually set on separate days. Layout planning comes first, since the installer wants full tiles in the most visible positions and cuts pushed to corners and edges.
Niches, benches, and accent bands slow things down. Each one requires additional waterproofing detail and careful cuts. They are worth it, but they should be in the plan and the schedule from the beginning.
After tile is set, thinset needs 24 to 48 hours before grouting. Grout then needs its own curing period before sealing and before the shower can be used. Corners and changes of plane get flexible silicone caulk rather than rigid grout, because those joints move slightly over time.
Phase Seven: Vanity, Fixtures and Finishing
With tile complete, the room moves quickly. The vanity is set and leveled, the countertop is installed, and the sink and faucet are connected. The toilet goes back in with a new wax ring or gasket. Trim, baseboards, mirrors, towel bars, and paint follow.
Final paint usually waits until after tile and trim, which limits the touch up work needed later. Use a paint rated for bathroom humidity to protect the finish over time.
Shower glass is the last major item. A glass company measures the finished opening, then fabricates the panels. That typically takes one to two weeks. Frameless glass takes longer than framed enclosures because the tolerances are tighter.
Punch List and Final Walkthrough
Walk the bathroom with the contractor. Check that drawers align, the door closes cleanly, the exhaust fan pulls air, the water drains without pooling, and the caulk lines are clean.
Run the shower for several minutes and watch how the water moves toward the drain. Check the ceiling below the next day if the bathroom is on a second floor. Most punch lists take one to three days to close out.
What Pushes a Bathroom Remodel Past Four Weeks
When bathroom projects run long, the cause is usually one of a handful of factors. None of them are mysterious, and most can be planned for.
Moving Plumbing in a Slab Home
Relocating a toilet or shower drain in a slab foundation means concrete cutting, plumbing, inspection, and a patch that must cure. This alone commonly adds a week and often triggers permit review.
Hidden Water Damage
This is the most frequent cause of schedule extension in bathroom remodels. A failed pan or a leaking valve can damage framing, subfloor, and insulation. The repair is necessary, and it changes the timeline.
Custom Glass and Special Order Items
Frameless glass, specialty vanities, imported tile, and unusual fixture finishes all carry longer lead times. Ordering these early is the difference between a smooth project and a stalled one.
Complex Tile Work
Intricate patterns, full height stone walls, curbless entries, and multi niche layouts take more labor hours. A curbless shower in particular requires subfloor modification to maintain proper slope, which adds days.
Doing Multiple Bathrooms at Once
Remodeling two bathrooms in sequence takes longer than one but less than double, since mobilization and material delivery are shared. If the plan eventually includes several rooms, coordinating them as part of a broader full house remodeling plan often reduces total time on site compared with separate projects months apart.
Sequencing matters when a bathroom is part of a larger plan. Kitchens are driven by cabinet lead time while bathrooms are driven by curing, so reviewing how long a kitchen remodel takes before booking both helps you decide which room to start first.
Three Bathroom Projects and Their Real Timelines
Scenario One: The Guest Bath Refresh
A hall bathroom keeps its tub and layout. New floor tile, new tub surround tile, new vanity and top, new toilet, new fixtures, new lighting, and fresh paint.
No permit is required. Planning takes about ten days. Construction runs roughly twelve working days, with cure times for tile and grout accounting for much of the calendar. Total project time is around three and a half weeks.
Scenario Two: The Tub to Shower Conversion
A 1990s primary bathroom replaces a garden tub with a tiled walk in shower in the same footprint. The drain moves about eighteen inches, which requires minor slab work and a permit.
Selections take two weeks. Permit approval takes one week. Construction runs four weeks including waterproofing, flood testing, and tile. Frameless glass adds ten days after tile is complete. Total project time lands near eight weeks.
Scenario Three: The Primary Suite Rebuild
A larger project expands the bathroom into an adjacent closet, adds a freestanding tub, builds a curbless shower with two niches and a bench, installs heated floors, and uses a custom double vanity.
Structural and plumbing work require permits and multiple inspections. Custom vanity lead time is nine weeks. Construction runs six to seven weeks. Total project time reaches three to four months. The scope, not the crew, sets that pace.
How to Keep Your Bathroom Remodel on Schedule
Homeowners influence the timeline more than they realize, and almost all of that influence happens before demolition.
Finalize every selection before work begins. Tile, grout color, vanity, top, faucet, shower valve trim, toilet, mirror, lighting, and glass style. Shower valves in particular must be chosen early, because the valve body is installed during rough in and cannot be swapped later without opening the wall.
Confirm all materials are on site and undamaged before demolition day. Tile from different production lots can vary slightly in shade, so having the full order on hand lets the installer blend boxes correctly.
Plan your bathroom access. If this is the only full bath in the house, arrange alternatives. Many contractors can keep a toilet functional for part of the project, but there will be days when the room is fully out of service. Ask which days those will be.
Respond quickly to questions. Tile layout decisions often need an answer on the spot. A delayed reply can stop a tile setter for a full day, and that day is hard to recover.
How Scope and Budget Affect the Schedule
Price and time are related but not identical. A generous budget spent on in stock materials and a simple layout can finish faster than a modest budget spent on custom pieces and a moved drain.
Labor intensity is the real driver. Mosaic tile costs more in labor hours than large format porcelain. A curbless shower costs more in framing time than a standard curbed one. Every hour of added craftsmanship is also an hour of added schedule.
A team that plans sequencing, ordering, and inspections together is what keeps scope and calendar aligned. Homeowners across Central Texas often find that the planning phase, not the construction phase, determines whether a project finishes on time.
Lead time for a start date matters too. Crews handling bathroom remodeling in Leander TX and the surrounding suburbs often book four to eight weeks out, and that gap is useful rather than wasted, since it covers selections and material delivery.
Living in the House During a Bathroom Remodel
Most families stay home during a bathroom remodel. Water to the rest of the house stays on except for short shutoffs during plumbing work. Dust control matters, since tile demolition produces fine particles that travel.
Ask for plastic barriers at the doorway and a path protected with floor covering from the entry to the bathroom. Confirm where the crew will place debris and when it will be hauled away.
If the house has only one bathroom, talk through the plan in detail. Some contractors can stage work so the toilet remains usable for most of the project. A gym membership or a nearby family member can cover the days when the room is closed.
Frequently Asked Questions About Bathroom Remodel Timeline
How long does a small bathroom remodel take?
A powder room or small guest bath with no shower usually takes seven to ten working days. Add a tiled shower and the range moves to two or three weeks because of waterproofing and curing steps. Planning and ordering typically add another one to two weeks before construction starts.
Can I use my bathroom during the remodel?
Not fully. The room is out of service from demolition until fixtures are reinstalled. In some projects the toilet can stay functional for part of the schedule. Ask your contractor which specific days the room will be completely unusable so you can plan around them.
Why does tile work take so many days in a small room?
Most of that time is waiting, not working. Thinset under tile needs 24 to 48 hours to cure before grouting. Grout needs time before sealing. Waterproofing membranes need cure time before tile can be set. Those pauses exist to prevent leaks and cracked grout later.
Do I need a permit to remodel a bathroom in Texas?
It depends on scope and city. Cosmetic updates such as new tile, a new vanity, or a new toilet in the same location generally do not require one. Moving plumbing, adding circuits, or changing the structure generally does. Your contractor should confirm the requirement with your specific municipality.
What is the most common cause of bathroom remodel delays?
Hidden water damage found during demolition is the most common cause. A shower that leaked slowly for years can damage framing and subfloor. The second most common cause is late material selection, especially shower valves and custom glass.
How far in advance should I book a bathroom remodel?
Four to eight weeks ahead is reasonable for most projects in Central Texas. Established contractors often book several weeks out, and that lead time is useful anyway since it can be spent finalizing selections and ordering materials.
Is it faster to replace a tub with a prefabricated shower unit?
Yes. A prefabricated unit installs in a day or two and avoids most waterproofing cure times. A fully tiled custom shower takes a week or more. The tradeoff is design flexibility, since tile allows custom sizes, niches, benches, and finishes that prefabricated units cannot match.
The Practical Takeaway
Plan for 2 to 4 weeks of construction and 4 to 10 weeks from first call to finished bathroom. Treat waterproofing cure times as fixed, not flexible. Choose your shower valve and glass style early. Budget a contingency for water damage in any home older than twenty years.
A bathroom built correctly is a room you stop thinking about. The tile stays tight, the grout stays clean, the pan stays dry, and the fan pulls humidity out before it becomes a problem. Those results come from sequence and patience more than from speed.
If you want a timeline based on your actual bathroom rather than a general range, the team at Rock Your House will walk the space, check the plumbing configuration and foundation type, and provide a written schedule with the estimate. Serving Cedar Park, Leander, Georgetown, and communities across Central Texas, Rock Your House handles design, ordering, permits, and inspections so the calendar stays realistic from day one. Reach out to schedule a consultation and get clear start and finish dates for your project.
